Bathroom questions
How long does a bathroom remodel take?
A good part of the schedule goes into steps you never see: ordering, inspections and testing. Here is the order of work on site and where schedules usually slip.
Aleksei Kasatkin, owner of ORCA Build Group · Updated October 26, 2026
Before anyone touches the room
The clock on site should not start until the materials are ordered and the scope is fixed. In this stage I measure the room, we confirm whether your address needs a permit, and you and I agree on every fixture, tile and vanity. Ordering happens here too. Some items ship in days, others take weeks, and I would rather wait for them before demolition than leave you with an open wall.
The work on site, in order
For a full remodel that keeps the layout, the work runs in this sequence. On a 2-week job the stages follow each other closely; on a 4-week job each one takes longer, usually because of a larger tile scope, repairs or inspections.
| Stage | What happens |
|---|---|
| Demolition | What happensTile, fixtures and drywall come out, debris is hauled away, and we see what is behind the walls. |
| Repairs | What happensAny rot or soft subfloor is photographed, priced and fixed after your approval. |
| Rough plumbing and electrical | What happensLicensed trade partners set the valve, drains, wiring, fan duct and GFCI-protected circuits. |
| Inspection, if permitted | What happensThe city inspector checks the rough work before the walls are closed. |
| Backer board and waterproofing | What happensCement board goes up, a membrane goes over it, and the shower pan is flood-tested for 24 hours. |
| Tile | What happensFloor and walls are set, then grouted. |
| Fixtures and finish | What happensVanity, toilet, trim, fan, lights and paint. |

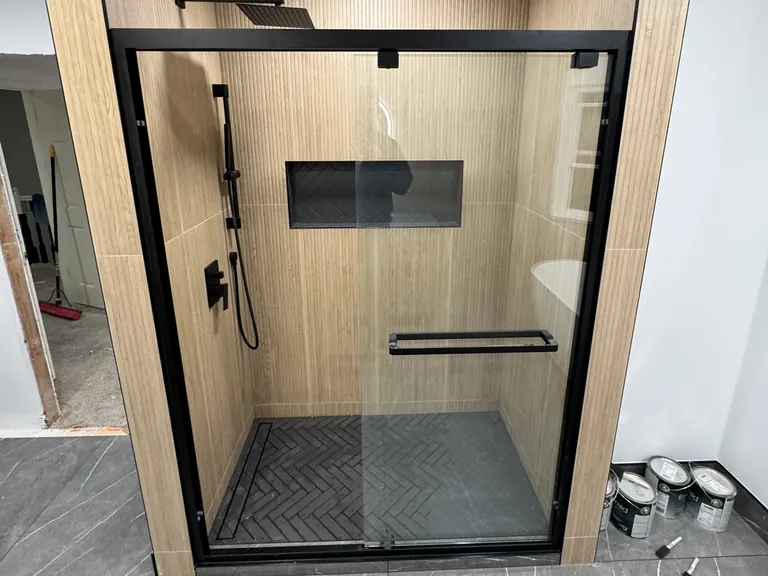

| Glass | What happensMeasured after the tile is done, then made to size and installed. |
| Final | What happensFinal inspection if permitted, and a walk-through with you. |
Our technical supervisor checks each stage before the next one starts. That takes hours, not days, and it costs far less than finding a problem under finished tile.




What usually causes delays
- Materials that are not on site. A vanity or valve on back order stops the job at the point where it is needed. This is the most common delay and the easiest to avoid.
- Hidden damage. Rot under an old tub or behind a leaking valve adds repair days. We photograph it and give you a price before continuing, so the decision is yours, but the decision itself takes time.
- Inspection scheduling. The city sets inspection dates, not us. A failed or rescheduled inspection moves everything after it.
- Glass. Frameless glass cannot be measured until the tile is finished, and it takes time to make. It is often the last item on the schedule.
- Changes mid-job. A different tile or a moved niche after work starts means reordering and redoing.
How to keep it short
- Choose every fixture and finish before demolition, and have it delivered.
- Keep fixtures where they are. Moving plumbing adds work and often a plan review.
- Answer hidden-damage questions the same day if you can.
- Ask for the schedule in writing with the stages listed, not just a total number of weeks.
If this is your only bathroom, tell me at the start. I plan the order of work so you are without a shower as few days as possible, and I tell you which days those are. More in our guide to remodeling your only bathroom.
What I cannot promise is an exact finish date before demolition, because nobody knows what is behind the walls until they are open. What I can do is give you a schedule in writing and tell you the same day if something changes it.
When will I know the schedule for my bathroom?
With the written estimate. It lists the stages and the expected time on site, it is free, and it holds for 14 days. If you send 2 or 3 photos first, I can give you a price range and a rough idea of time before the site visit.
Does a permit make the job longer?
Usually, yes. The rough inspection has to happen before the walls are closed, and the final one at the end, and the city sets both dates. We confirm permit needs for your address before the contract, so inspection time is in the schedule from the start.
Related questions
- How much does a bathroom remodel cost in the Bay Area?
- How do I live through a remodel of my only bathroom?
- Should I buy the fixtures myself or let the contractor supply them?
- All bathroom guides
Codes and permit rules change, and each Bay Area city applies them a little differently. Treat this page as a starting point and confirm the requirements for your address before work begins. We do that as part of every written estimate.
Have a bathroom question this page did not answer?
Send 2–3 photos and tell me what bothers you about the room. I reply with a price range and what I would check first.
